Description
Every mechanical fixing driven into an insulation board leaves an interruption in the insulation plane and a disc bearing on the board face. Capping closes both, and these caps sit in the insulation fixing accessories range at Renders World, beside the plugs whose heads they cover.
Where Plug Caps Close the Insulation Face

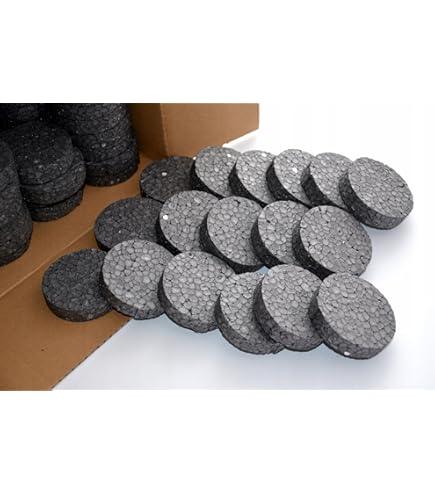

The Grey EPS Plug Caps 100pcs pack, listed at £8.40 in August 2026, seats into the countersunk recess over each mechanical fixing so the insulation face returns to a flat plane before basecoat. The pack holds 100 caps, which is the quantity its own name carries.
That single step decides how the reinforcing layer behaves. A capped fixing gives the renderer continuous board to trowel across, while an exposed disc has to be bridged at every point in the pattern.
- On the board — the cap fills the recess and returns a flat face, so the basecoat is spread rather than feathered around each head.
- On the insulation layer — insulation goes back over the plug head, keeping the layer continuous where the fixing passes through it.
- On the sequence — capping is the third move of the fixing stage, after driving the plug and cutting the recess, and the EWI fixings installation guide takes that order end to end.
Why Installers Cap Every Fixing Head
A bag of caps is a small line on a materials schedule that changes what the finished elevation looks like under low sun, which is why it goes on the order with the plugs rather than after them.
- Priced openly at £8.40 per pack, as displayed in August 2026, so cap quantities can be scheduled without a quote request.
- Listed in stock at the time of the crawl, on the same site as the plugs, discs, tracks and countersink tooling that make up the stage.
- Supplied 100 to the pack, a count that matches how a fixing schedule is written — plug count first, cap count to follow it.
- Grey against white board — the colour difference turns the pre-basecoat walk-round into a one-glance check for a fixing that was missed.
- Ordered with the boards they cap — the graphite EPS insulation boards arrive on the same delivery as the fixings and the caps that finish them.
How to Confirm Cap Size Before You Order
No manufacturer data sheet, declaration or distributor mirror for these caps could be retrieved in this session, and the searches returned only comparable caps from other suppliers. Renders World publishes what the live listing supports and names the rest as a check at the order line.
- Published here — the price and the stock state read from the listing, and the pack count carried in the product's own name, each dated to the month it was read.
- Not published here — cap diameter, cap thickness, material grade, thermal conductivity and coverage per pack, none of which any retrieved document supports for this product.
- Worth knowing before you match anything — cap thickness varies between manufacturers even where the diameter is shared, so a figure quoted for another supplier's cap is not a specification for this one.
- Settled on the first recess of the day — cut one pocket, bed one cap and look along the board; that test answers diameter, thickness and adhesive allowance together.
Doing that test before the pass begins is a step worth getting right, because it is the point where a cap either sits level with the board or tells you to change the recess.
Fitting Caps Into a Countersunk Recess
Caps go in after the plugs are driven and the recesses are cut, working the elevation in the same order the fixings were set out.
- Clear the pocket — brush out dust and loose material so the adhesive meets clean board rather than debris.
- Bed the cap — a dab of foam adhesive or a thin spread of the basecoat mortar already mixed for the next stage, applied to the back of the cap.
- Press to level — push until palm pressure stops moving it, aiming for flush with the surrounding board or a whisker below.
- Check along the board — lay a short straight edge across the cap and two neighbouring points; a cap standing proud comes back out, gets the surplus adhesive trimmed off and goes in again while everything is still workable.
- Walk the elevation — a lap before basecoat catches an uncapped fixing in seconds, which is far quicker than reaching one through a cured reinforcing layer.
Where the caps land is set by the fixing layout rather than by the caps, and that layout is a system and manufacturer figure. The fixing pattern and spacing guide works through it across the field and around openings.
Adhesive, Seating Depth and Timing on a Capping Run
Adhesive choice usually follows what is already open on site. Foam holds quickly and takes up small irregularity in the recess wall; basecoat mortar puts the same material behind the cap as goes over it, which keeps one product doing two jobs.
- Read the adhesive, not the cap — working temperatures and the time before basecoat belong to whatever is bedding the cap, so those figures come off that product's label.
- Flush or fractionally below — a slight recess is filled by the basecoat, so aiming just under the board face leaves the most margin.
- Cap a whole elevation in one run — one adhesive batch and one seating rhythm give a more consistent face than a wall split across two visits.
- Start where the datum was set — the base track and first course established the pattern the recesses follow, a sequence covered in the first-day base track setup guide.
Where Caps Sit Beside Plugs, Recesses and Basecoat
| Your Stage | What Handles It | Where the Detail Sits |
|---|---|---|
| Anchoring the board | Plugs, discs and anchors | Plug length calculation method |
| Recessing the plug head | Countersink tooling | Plugs, discs and countersink tools |
| Capping and reinforcing | These caps, then mesh and basecoat | Fixings and capping sequence |
Read down the table and the cap is one of three moves at a single stage, which is the argument for ordering all three together rather than discovering the third on capping day.
Choosing Caps for Your Fixing Schedule
- Specify them on mechanically fixed polystyrene elevations — wherever plug heads are recessed and a flat, uninterrupted face is wanted under the reinforcing layer.
- Match cap to recess on arrival — one test cap settles the fit, and it is worth doing before the pass rather than after it.
- For mineral wool slabs, ask the system designer — slabs from the mineral wool insulation range are capped to that system's own specification, which is a different question from a polystyrene elevation.
- Schedule caps against plug count — one order covering boards from the graphite insulation board range, plugs, tooling and caps keeps the whole stage on one delivery.
Renders World shows the price and the stock state on the listing, and the dimensional questions this page leaves open are the ones to put to the supplier rather than to infer from a comparable cap.
FAQ: Cap Quantities, Fit and Site Practice
How many packs does an elevation need?
Cap count follows plug count exactly, so take the number of fixings from the layout the system specifies and divide by the 100 in the pack. No per-square-metre figure is published here, because the fixings-per-square-metre value is a manufacturer and system figure rather than a rule of thumb, and the fixing pattern and spacing guide is where it is established. Ordering one pack beyond the calculation covers caps lost to a recess that needed recutting.
Will they fit the recesses already cut on site?
Check with one cap before the run, since no diameter or thickness is published on the listing and cap dimensions differ between suppliers. A cap that drops in with a little room behind it for adhesive is right; one that stands above the board face or swims in the pocket points to a mismatch between tool and cap, and finding that out on a single fixing costs nothing.
Can grey caps be used on white insulation boards?
Fit is a question of recess size rather than board colour, so the same check applies either way. The visible contrast is an advantage while the wall is open, as a grey cap on a white board makes an uncapped fixing obvious from the ground, and everything disappears under the basecoat once the reinforcing layer goes on.
What is the fix if a cap ends up sitting proud?
Take it out, pare the excess adhesive off the back and reseat it level, which is a two-minute job while the bed is still green. Catching it at the straight-edge check keeps the correction at that stage, and it is the reason the pre-basecoat walk-round is worth the ten minutes it takes on a full elevation.
